South Park Drive Improvement Project
The South Park Drive Improvement Project affects approximately 1.1 miles of roadway. The roadway to be improved is South Park Drive from Highway 13 to County Road 27. The proposed improvement is a full depth mill & overlay that includes installation of pedestrian crossings and median treatments. South Park Drive from Highway 13 to Louisiana Avenue would be converted to a 3-lane roadway. South Park Drive is a Municipal State Aid route, so Municipal State Aid Construction funds will constitute the primary funding source.
The South Park Drive Improvement Project affects approximately 1.1 miles of roadway. The roadway to be improved is South Park Drive from Highway 13 to County Road 27. The proposed improvement is a full depth mill & overlay that includes installation of pedestrian crossings and median treatments. South Park Drive from Highway 13 to Louisiana Avenue would be converted to a 3-lane roadway. South Park Drive is a Municipal State Aid route, so Municipal State Aid Construction funds will constitute the primary funding source.
-
August 15 - 22, 2025
Share August 15 - 22, 2025 on Facebook Share August 15 - 22, 2025 on Twitter Share August 15 - 22, 2025 on Linkedin Email August 15 - 22, 2025 linkPhase 1 (Louisiana to CR 27) and Phase 2 (Quebec Ave to Louisiana Ave)
- Crews will be working on landscaping the median with hydroseeding, plants and trees on Wednesday.
- The final lift of asphalt will be laid down on Friday, August 22 weather permitting.
Phase 3 (East of Quebec Ave to Hwy 13)
- Storm sewer work will continue.
- The removal of curb, gutter, sidewalks and driveways will be worked all week.
The Louisiana Avenue & South Park Drive roundabout will be closed to traffic during the early hours of Friday, August 22 and Monday, August 25 from 4:00 a.m. to 6:00 a.m. to complete milling and paving of the roundabout.
QUESTIONS? Please contact John Wichman at 612-890-8744.
Thank you!
-
Revised August 8, 2025
Share Revised August 8, 2025 on Facebook Share Revised August 8, 2025 on Twitter Share Revised August 8, 2025 on Linkedin Email Revised August 8, 2025 linkWe have received an update to the traffic control information that was sent out earlier today.
-
Phase 3 (East of Quebec Ave to Hwy 13)
-
Revised: Please be aware of traffic control changes beginning on Tuesday, August 12 (not Monday as previously stated):
- Hwy 13 South Frontage Road to Quebec will be open to Eastbound traffic only through August 17.
- Phase 3 will be shut down completely beginning August 18 until further notice. Watch for further updates as to when it may open.
-
Revised: Please be aware of traffic control changes beginning on Tuesday, August 12 (not Monday as previously stated):
-
Phase 3 (East of Quebec Ave to Hwy 13)
-
August 8, 2025
Share August 8, 2025 on Facebook Share August 8, 2025 on Twitter Share August 8, 2025 on Linkedin Email August 8, 2025 linkPhase 3 (East of Quebec Ave to Hwy 13)
- Crews will begin Storm Sewer work on Monday, August 12. This work will take approximately 2 weeks.
- Please be aware of traffic control changes beginning on Monday, August 12:
- Hwy 13 South Frontage Road to Quebec will be open to Eastbound traffic only for approximately 2 weeks.
- Once the Storm Sewer work is complete, Phase 3 will then be shut down completely for approximately another 2 weeks.
Questions? Please call John Wichman at 612-490-8744.
Thank you!
-
August 1, 2025
Share August 1, 2025 on Facebook Share August 1, 2025 on Twitter Share August 1, 2025 on Linkedin Email August 1, 2025 linkPhase 1 (Louisiana to CR 27) and Phase 2 (Quebec Ave to Louisiana Ave):
- Happy to report that Phase 1 and 2 are now open for traffic! The last lift of asphalt along with the median planting will take place this fall.
Phase 3:
- Crews will continue working on relocating small utilities through August 11.
Questions? Please call John Wichman at 612-490-8744.
-
July 28 Construction Update
Share July 28 Construction Update on Facebook Share July 28 Construction Update on Twitter Share July 28 Construction Update on Linkedin Email July 28 Construction Update linkMonday & Tuesday
- Restoration will begin in boulevards and yards in Phase 1 (Louisiana to CR 27) and Phase 2 (Quebec Ave to Louisiana Ave) in preparation for opening up this area to traffic soon.
Wednesday
- Installation of the 2nd lift of asphalt will take place in Phase 1.
We are having an unexpected delay in Phase 3 due to issues in relocating small utilities. This work will continue until August 11.
Questions? Please call John Wichman at 612-490-8744.
Thank you.
-
July 21-25
Share July 21-25 on Facebook Share July 21-25 on Twitter Share July 21-25 on Linkedin Email July 21-25 linkHere are your construction updates for next week.
Monday, July 21st
- Crews will be working on concrete medians and raising of the utility covers for Phase 2 portion of the project (street segment from Quebec Avenue to Louisiana Avenue – roundabout)
Tuesday, July 22nd
- Paving of the second layer of bituminous pavement will take place for Phase 2. Phase 1 portion of the project (from Louisiana to County Road 27) will see minor work to prepare for paving of the second layer of bituminous pavement. The placement of the second layer of bituminous for Phase 1 is scheduled for Monday, July 28th.
Wednesday, July 23rd through Friday, July 25th
- Phase 2 portion of the project will see placement of topsoil and preparation for restoration of the impacted areas. Once topsoil placement is complete, the segment of South Park Drive from Quebec to Louisiana will be opened to traffic. Phase 3 portion of the project (Quebec to Highway 13) will continue with utility work.
-
July 10 - 15
Share July 10 - 15 on Facebook Share July 10 - 15 on Twitter Share July 10 - 15 on Linkedin Email July 10 - 15 linkConstruction Update: July 10 - 15
Phase I: (CR 27 to Louisiana Ave)
Yard restoration will continue.
Phase II (Louisiana Ave to East of Quebec Ave):
Thursday, 7/10 – Our crews will be paving the pedestrian trail.
Friday, 7/11 – We'll be placing concrete curb & gutter in the medians. In the event of rain on Friday, the work will be moved to Monday, 7/14 .
Tuesday, 7/15 – Reclaiming of the street will begin along with preparing for laying the first lift of asphalt.
Phase III (East of Quebec Ave to Hwy 13)
Tuesday, 7/15 – Work will begin in Phase III.
Tuesday, 7/15 – Small utilities and fire hydrants will be relocated in preparation for the road construction.

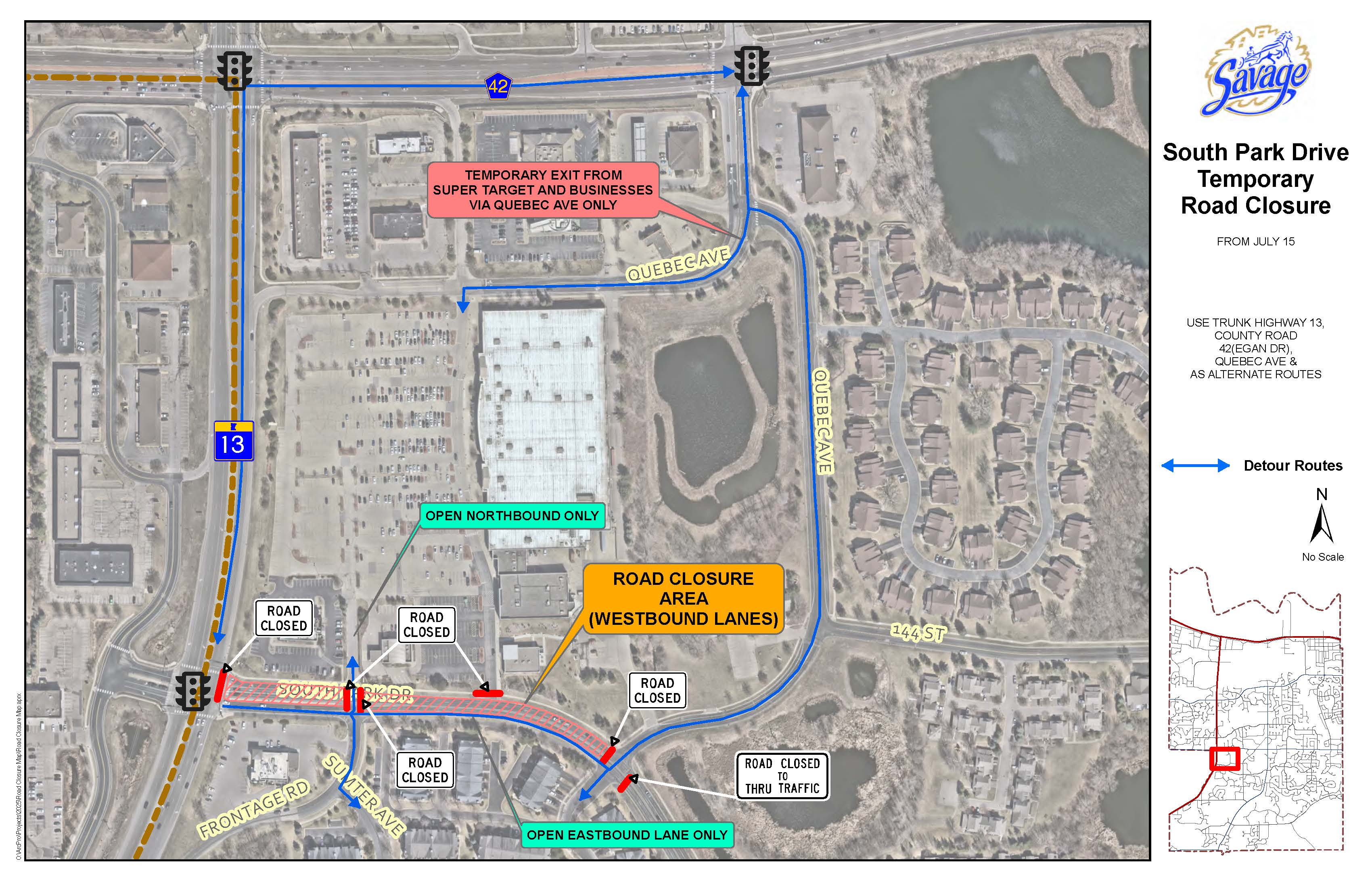

TEMPORARY ROAD CLOSURE: The Westbound lane will be temporarily closed from Quebec to Hwy 13. See map.
-
June 30 - July 4, 2025
Share June 30 - July 4, 2025 on Facebook Share June 30 - July 4, 2025 on Twitter Share June 30 - July 4, 2025 on Linkedin Email June 30 - July 4, 2025 linkPhase I - Trail construction
Phase II - Concrete driveway, curb & gutter and sidewalk placement
No work on Friday, July 4.
-
June 18 - 27, 2025
Share June 18 - 27, 2025 on Facebook Share June 18 - 27, 2025 on Twitter Share June 18 - 27, 2025 on Linkedin Email June 18 - 27, 2025 linkPhase I
- First lift of asphalt will be laid.
- Prepping & paving trails.
- Continue with irrigation repairs and yard grading.
Phase II
- REMINDER: Phase II begins.
- Begin removal of curb, gutter & sidewalks
-
June 16 - 23, 2025
Share June 16 - 23, 2025 on Facebook Share June 16 - 23, 2025 on Twitter Share June 16 - 23, 2025 on Linkedin Email June 16 - 23, 2025 linkMonday, June 16 - Reclaiming roadway in Phase I
Tuesday - Thursday - Subgrade prep for road & trails
Friday - Saturday - Subgrade Stabilization
Monday, June 23 - Paving of 1st lift of pavement in Phase I. Removals will begin in Phase II.
05.01.25 Neighborhood Meeting Notice
Resident Brochure
01.08.25 Neighborhood Meeting Presentation
Follow Project
Who's Listening
-
Phone 9528822671 Email smeyer@savagemn.gov -
Phone 952-224-3419 Email sthongvanh@savagemn.gov
Key Dates
-
August 07 2024
