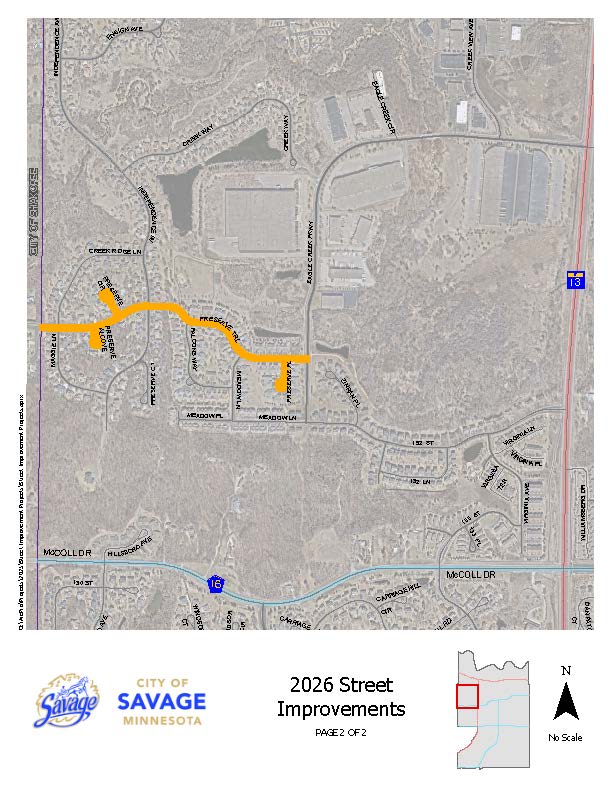

2026 Street Improvement Project
The City Council has ordered the preparation of a feasibility report for the streets proposed to be improved in 2026. Below is a map showing the streets that will be evaluated for inclusion in the 2026 Street Improvement Project. Streets may be added or removed depending on the available budget.


The City Council has ordered the preparation of a feasibility report for the streets proposed to be improved in 2026. Below is a map showing the streets that will be evaluated for inclusion in the 2026 Street Improvement Project. Streets may be added or removed depending on the available budget.


-
Construction Update Week of June 8
Share Construction Update Week of June 8 on Facebook Share Construction Update Week of June 8 on Twitter Share Construction Update Week of June 8 on Linkedin Email Construction Update Week of June 8 linkPhase 1 & 2
- All week: Restoration crews will start placing topsoil in boulevards in preparation for sod. Sod to follow soon! Watch for a mailing to be sent soon after sod is placed regarding sod care and warranty information.
-
Wednesday - Friday: Pond excavation work will begin.
-
If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link)(External link)(External link)(External link).
Phase 3 & 4 (Preserve Trail)
- Utility work will begin.
- Marked curb will be removed.
- Old pedestrian ramps will be removed, and grading will take place in preparation for the new ramps.
-
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
Phase 1 & 2
- All week: Restoration crews will start placing topsoil in boulevards in preparation for sod. Sod to follow soon! Watch for a mailing to be sent soon after sod is placed regarding sod care and warranty information.
-
Wednesday - Friday: Pond excavation work will begin.
-
If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link)(External link)(External link)(External link).
Phase 3 & 4 (Preserve Trail)
- Utility work will begin.
- Marked curb will be removed.
- Old pedestrian ramps will be removed, and grading will take place in preparation for the new ramps.
-
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
-
Construction Update for Week of June 1
Share Construction Update for Week of June 1 on Facebook Share Construction Update for Week of June 1 on Twitter Share Construction Update for Week of June 1 on Linkedin Email Construction Update for Week of June 1 link- Saturday, May 30 Crews will be working to prepare subgrade for paving that will take place later in the week.
- Monday & Tuesday, 6/1-6/2 Crews will wrap up the final grading and compaction work. Excavation of the pond will begin Monday and continue throughout the week.
- Wednesday (6/3) Crews will begin laying the first lift of fresh asphalt on the following streets: Colorado Ave, Brunswick Ave, Alabama Ave cul-de-sac, Zarthan Ave, 139th St, Yosemite Circle, and Yosemite Court.
- Thursday, 6/4 Crews will begin laying the first lift of fresh asphalt on the following streets: 140th Street, Alabama Ave, Yosemite Ave and 144th Street.
- Friday, 6/5 Topsoil placement will begin as part of the restoration of the boulevards.
-
Important Information About Paving Days
Parking Requirements
- No street parking allowed on paving days
- Keep all vehicles in your driveway or park on nearby streets outside the construction zone
-
Access During Paving
- You'll still be able to get in and out of your driveway throughout the paving process. However, if the paving equipment is working directly in front of your home, you may need to wait 15-30 minutes for the asphalt to cool down before driving over it. Our crew will help coordinate your access and get you in and out as quickly as possible.
- Safety Reminders Please drive carefully through the construction area. You may need to navigate around equipment, and conditions can change throughout the day.
- Construction will be moving to Phase 3 and 4 (Preserve Trail) starting mid-week with curb marking and saw cutting work of curb that will be replaced (weather permitting).
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link)(External link)(External link).
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
- Saturday, May 30 Crews will be working to prepare subgrade for paving that will take place later in the week.
- Monday & Tuesday, 6/1-6/2 Crews will wrap up the final grading and compaction work. Excavation of the pond will begin Monday and continue throughout the week.
- Wednesday (6/3) Crews will begin laying the first lift of fresh asphalt on the following streets: Colorado Ave, Brunswick Ave, Alabama Ave cul-de-sac, Zarthan Ave, 139th St, Yosemite Circle, and Yosemite Court.
- Thursday, 6/4 Crews will begin laying the first lift of fresh asphalt on the following streets: 140th Street, Alabama Ave, Yosemite Ave and 144th Street.
- Friday, 6/5 Topsoil placement will begin as part of the restoration of the boulevards.
-
Important Information About Paving Days
Parking Requirements
- No street parking allowed on paving days
- Keep all vehicles in your driveway or park on nearby streets outside the construction zone
-
Access During Paving
- You'll still be able to get in and out of your driveway throughout the paving process. However, if the paving equipment is working directly in front of your home, you may need to wait 15-30 minutes for the asphalt to cool down before driving over it. Our crew will help coordinate your access and get you in and out as quickly as possible.
- Safety Reminders Please drive carefully through the construction area. You may need to navigate around equipment, and conditions can change throughout the day.
- Construction will be moving to Phase 3 and 4 (Preserve Trail) starting mid-week with curb marking and saw cutting work of curb that will be replaced (weather permitting).
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link)(External link)(External link).
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
-
Construction Update for Week of May 25
Share Construction Update for Week of May 25 on Facebook Share Construction Update for Week of May 25 on Twitter Share Construction Update for Week of May 25 on Linkedin Email Construction Update for Week of May 25 link- Crews will not be working on Monday, May 25 in observance of the Memorial Day Holiday.
- Pavement removal will begin on Tuesday through Wednesday.
- After the pavement is removed, crews will work on lowering manholes and gate valves on Wednesday and Thursday.
- Towards the end of the week (Thursday/Friday), grading / blading will take place to shape the aggregate base.
- Construction will be moving to Phase 3 and 4 (Preserve Trail) starting June 1 (weather permitting).
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link)(External link).
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure located to the right under documents.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
- Crews will not be working on Monday, May 25 in observance of the Memorial Day Holiday.
- Pavement removal will begin on Tuesday through Wednesday.
- After the pavement is removed, crews will work on lowering manholes and gate valves on Wednesday and Thursday.
- Towards the end of the week (Thursday/Friday), grading / blading will take place to shape the aggregate base.
- Construction will be moving to Phase 3 and 4 (Preserve Trail) starting June 1 (weather permitting).
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link)(External link).
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure located to the right under documents.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
-
Construction Update for Week of May18
Share Construction Update for Week of May18 on Facebook Share Construction Update for Week of May18 on Twitter Share Construction Update for Week of May18 on Linkedin Email Construction Update for Week of May18 link- Residents affected by the new concrete curb & gutter installation have received a flyer with parking information. Please remember to remove needed vehicles, campers & boats from your driveway before 7:00 a.m. on the day of your installation.
- Curb & Gutter replacement will be complete by the end of Tuesday, weather permitting.
- Wednesday, Thursday & Friday are reserved for rain makeup or for finishing up any loose ends regarding concrete work.
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link).
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure located to the right under documents.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
- Residents affected by the new concrete curb & gutter installation have received a flyer with parking information. Please remember to remove needed vehicles, campers & boats from your driveway before 7:00 a.m. on the day of your installation.
- Curb & Gutter replacement will be complete by the end of Tuesday, weather permitting.
- Wednesday, Thursday & Friday are reserved for rain makeup or for finishing up any loose ends regarding concrete work.
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov(External link).
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure located to the right under documents.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
-
Construction Update May 12
Share Construction Update May 12 on Facebook Share Construction Update May 12 on Twitter Share Construction Update May 12 on Linkedin Email Construction Update May 12 link

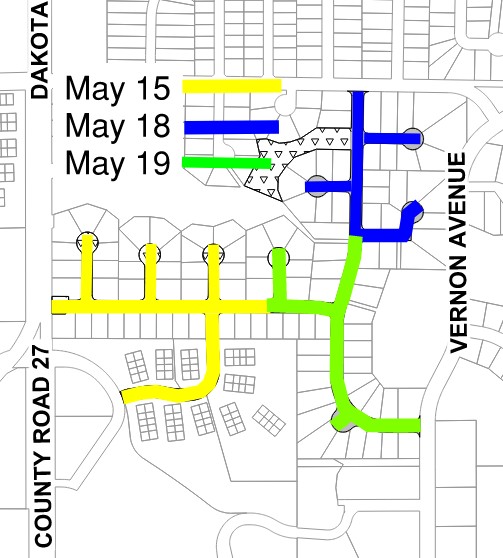

- New concrete curb & gutter will be installed May 15th, May 18th & May 19th.
- Remove needed vehicles, trailers, campers and boats out of your driveways before 7 a.m. on the day of your installation. See map below.
- Do not park or drive on the new curb or driveway for a minimum of seven days.
- Park in an area that is not under construction or where existing curb was not removed.
- After the Contractor is no longer working, you may park on the street in front of your home.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
- New concrete curb & gutter will be installed May 15th, May 18th & May 19th.
- Remove needed vehicles, trailers, campers and boats out of your driveways before 7 a.m. on the day of your installation. See map below.
- Do not park or drive on the new curb or driveway for a minimum of seven days.
- Park in an area that is not under construction or where existing curb was not removed.
- After the Contractor is no longer working, you may park on the street in front of your home.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
- New concrete curb & gutter will be installed May 15th, May 18th & May 19th.
-
Construction Update Week of May 11
Share Construction Update Week of May 11 on Facebook Share Construction Update Week of May 11 on Twitter Share Construction Update Week of May 11 on Linkedin Email Construction Update Week of May 11 linkThank you for signing up on Let's Talk Savage for updates on the 2026 Street Improvement Project in your neighborhood.
Week of May 11, 2026
-
Phase 1:
- New Storm Sewer installation will begin on Alabama Avenue, Zarthan Avenue & 140th Street.
- Crews will finish removing concrete sidewalk panels on Monday & Tuesday. Finish removing curb & gutter that has been marked for removal.
- Later in the week, new concrete pedestrian ramps will begin.
- At the end of the week, new concrete curb & gutter will be installed. Please watch for informational flyers on your door regarding this activity.
-
Phase 2:
- Crews will be replacing bolts on the gate valves that are part of the water main. They will be working on Yosemite Avenue, 139th Street, Yosemite Circle & Court, & 141st Street.
-
Phase 1 & 2:
- Please continue getting your mail in the temporary mailboxes located on Connelly Parkway.
- Expect some heavy equipment and trenching which may cause minor delays.
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov.
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure located to the right under documents.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
Thank you for signing up on Let's Talk Savage for updates on the 2026 Street Improvement Project in your neighborhood.
Week of May 11, 2026
-
Phase 1:
- New Storm Sewer installation will begin on Alabama Avenue, Zarthan Avenue & 140th Street.
- Crews will finish removing concrete sidewalk panels on Monday & Tuesday. Finish removing curb & gutter that has been marked for removal.
- Later in the week, new concrete pedestrian ramps will begin.
- At the end of the week, new concrete curb & gutter will be installed. Please watch for informational flyers on your door regarding this activity.
-
Phase 2:
- Crews will be replacing bolts on the gate valves that are part of the water main. They will be working on Yosemite Avenue, 139th Street, Yosemite Circle & Court, & 141st Street.
-
Phase 1 & 2:
- Please continue getting your mail in the temporary mailboxes located on Connelly Parkway.
- Expect some heavy equipment and trenching which may cause minor delays.
- If you have irrigation damage from construction, please contact Sue with your address @ 952-882-2671 or smeyer@savagemn.gov.
Note: This information is general project information. If you have specific questions regarding the impacts to your property, please contact Craig directly. Phasing areas are specified on the construction brochure located to the right under documents.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for your patience!
-
Phase 1:
-
Construction Update Week of 5/4
Share Construction Update Week of 5/4 on Facebook Share Construction Update Week of 5/4 on Twitter Share Construction Update Week of 5/4 on Linkedin Email Construction Update Week of 5/4 linkThank you for signing up on Let's Talk Savage for updates on the 2026 Street Improvement Project in your neighborhood.
Week of May 4, 2026
-
Phase 1:
- Crews will be replacing bolts on the gate valves that are part of the water main. They will start on Colorado Avenue and will work to the east.
- New Storm Sewer installation will begin on Colorado Avenue and will work to the east.
- Concrete sidewalk panels will be removed Tuesday or Wednesday at the intersections of 140th Street. Crews will be removing dirt and placing new gravel in preparation for new pedestrian ramps that will be installed in a few weeks.
- Phase 1 & 2:
This information is general project information. If you have specific questions regarding the impacts to your property, please contact us directly.
Questions? Please call Craig Svoboda at 612-490-8748.
Thank you for signing up on Let's Talk Savage for updates on the 2026 Street Improvement Project in your neighborhood.
Week of May 4, 2026
-
Phase 1:
- Crews will be replacing bolts on the gate valves that are part of the water main. They will start on Colorado Avenue and will work to the east.
- New Storm Sewer installation will begin on Colorado Avenue and will work to the east.
- Concrete sidewalk panels will be removed Tuesday or Wednesday at the intersections of 140th Street. Crews will be removing dirt and placing new gravel in preparation for new pedestrian ramps that will be installed in a few weeks.
- Phase 1 & 2:
This information is general project information. If you have specific questions regarding the impacts to your property, please contact us directly.
Questions? Please call Craig Svoboda at 612-490-8748.
-
Phase 1:
-
Construction Update 4/27/26
Share Construction Update 4/27/26 on Facebook Share Construction Update 4/27/26 on Twitter Share Construction Update 4/27/26 on Linkedin Email Construction Update 4/27/26 link- Crews will begin tree cutting Monday, 4/27/26 and will be done Wednesday, 4/29/26.
- Pipe crews will start in Phase 1.
- Xcel will be removing streetlights in Phases 1 & 2 in preparation for installing new storm sewer. They will be replaced when work is complete.
- Crews will begin tree cutting Monday, 4/27/26 and will be done Wednesday, 4/29/26.
- Pipe crews will start in Phase 1.
- Xcel will be removing streetlights in Phases 1 & 2 in preparation for installing new storm sewer. They will be replaced when work is complete.
-
Construction Update 4/17/26
Share Construction Update 4/17/26 on Facebook Share Construction Update 4/17/26 on Twitter Share Construction Update 4/17/26 on Linkedin Email Construction Update 4/17/26 linkConstruction Update
Thank you for signing up on Let's Talk Savage for updates on the 2026 Street Improvement Project in your neighborhood.
Here's what is happening next week:
April 17, 2026
McNamara Contracting will be onsite next week preparing for construction which will begin on Monday, April 27.
- Crews will be installing inlet protection devices in the catch basins.
- Saw cutting of marked curbs & sidewalks will begin.
We look forward to working with you this summer. Construction schedules can be tricky at times, not to mention the weather, but we will do our best to communicate timely.
Questions? Please call Craig Svoboda at 612-490-8748.
Kind regards,
The Project Team
Construction Update
Thank you for signing up on Let's Talk Savage for updates on the 2026 Street Improvement Project in your neighborhood.
Here's what is happening next week:
April 17, 2026
McNamara Contracting will be onsite next week preparing for construction which will begin on Monday, April 27.
- Crews will be installing inlet protection devices in the catch basins.
- Saw cutting of marked curbs & sidewalks will begin.
We look forward to working with you this summer. Construction schedules can be tricky at times, not to mention the weather, but we will do our best to communicate timely.
Questions? Please call Craig Svoboda at 612-490-8748.
Kind regards,
The Project Team
Key Dates
-
April 08 2026
-
December 15 2025
-
December 10 2025
Neighborhood Meetings
-
2026 Street Improvement Brochure.pdf (2.19 MB) (pdf)
-
040826 Neighborhood Meeting Notice.pdf (2.42 MB) (pdf)
-
Neighborhood Meeting Presentation 121025.pdf (3.01 MB) (pdf)
-
121025 Neighborhood Meeting.pdf (2.38 MB) (pdf)
-
Public Hearing Notice.pdf (95.9 KB) (pdf)
-
Feasibility Report 26-01 Final.pdf (6.23 MB) (pdf)
