2025 Street Improvement Project
Each year, the City performs maintenance on various segments of the City's road system to maximize the useful life of the pavement. The maintenance treatment can vary from crack sealing, seal coating, or patching up to complete reconstruction depending on the condition of the roadway. In order to determine the appropriate treatment, the City uses a Pavement Management Program (PMP). As part of this program, each street within the City has been surveyed, and its condition rated. Based on this rating, roadways are identified for inclusion in the City's annual Street Improvement Program and shown on the City's 10-Year Street Improvement Plan.

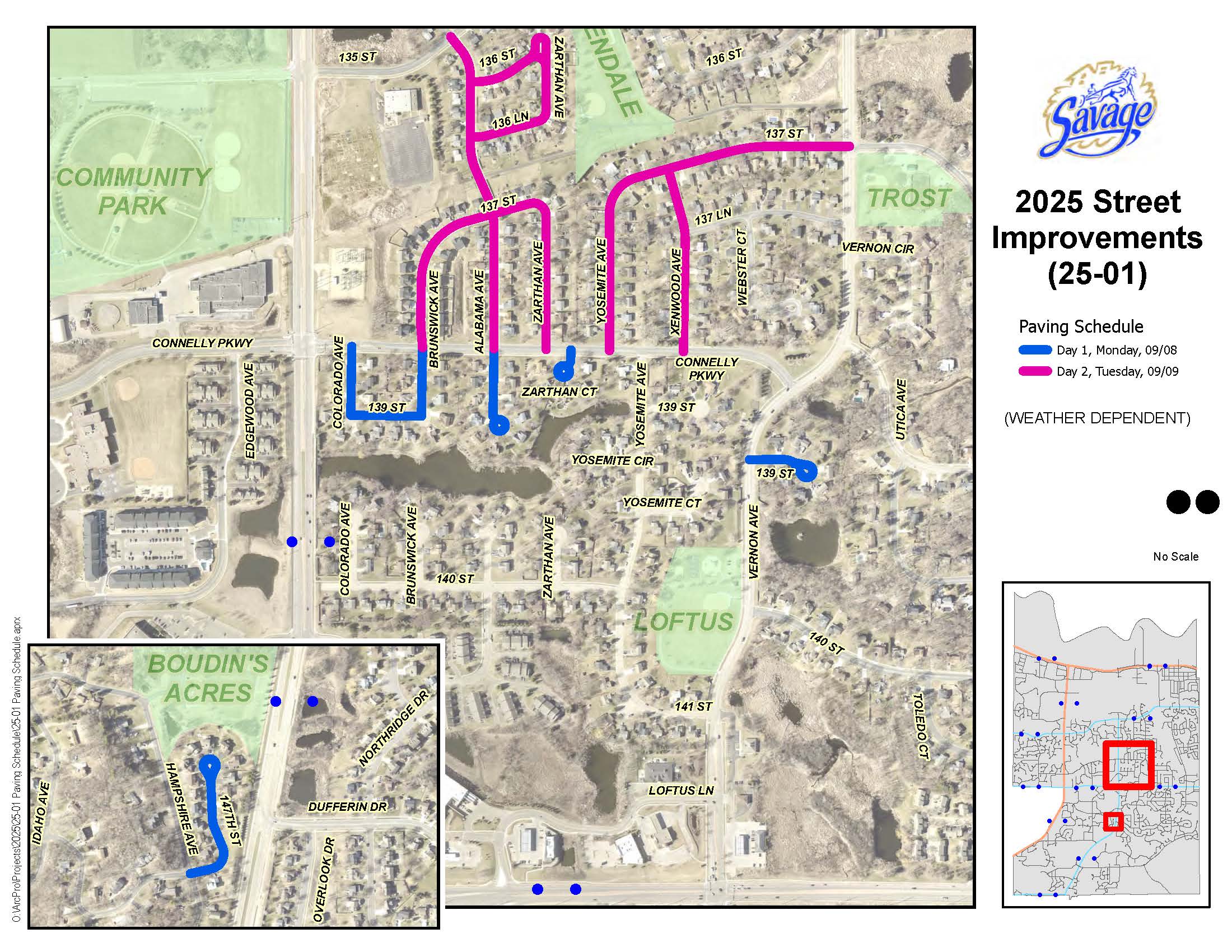

The 2025 Street Improvement Project affects approximately 1.8 miles of roadway. Proposed roadways to be improved are shown on the map below and include Colorado Ave., 139th St., Brunswick Ave., 137th S., Alabama Ave., Zarthan Ave., Zarthan Ct., Yosemite Ave., Xenwood Ave., 136th St., 136th Ln., and 147th St.
See below for ongoing updates for the 2025 Neighborhood Street Project. Please check back periodically.
Each year, the City performs maintenance on various segments of the City's road system to maximize the useful life of the pavement. The maintenance treatment can vary from crack sealing, seal coating, or patching up to complete reconstruction depending on the condition of the roadway. In order to determine the appropriate treatment, the City uses a Pavement Management Program (PMP). As part of this program, each street within the City has been surveyed, and its condition rated. Based on this rating, roadways are identified for inclusion in the City's annual Street Improvement Program and shown on the City's 10-Year Street Improvement Plan.
The 2025 Street Improvement Project affects approximately 1.8 miles of roadway. Proposed roadways to be improved are shown on the map below and include Colorado Ave., 139th St., Brunswick Ave., 137th S., Alabama Ave., Zarthan Ave., Zarthan Ct., Yosemite Ave., Xenwood Ave., 136th St., 136th Ln., and 147th St.
See below for ongoing updates for the 2025 Neighborhood Street Project. Please check back periodically.
-
August 15 - 22, 2025
Share August 15 - 22, 2025 on Facebook Share August 15 - 22, 2025 on Twitter Share August 15 - 22, 2025 on Linkedin Email August 15 - 22, 2025 linkHere are the updates for the upcoming week!
- Crews will be finishing up sod today and will work part of Saturday, 8/16, if needed.
- Disturbed landscaping items will be taken care of late in the week or the following.
- Most of the irrigation systems have been repaired. If anything needs to be revisited, please let us know asap.
- Remaining concrete work/repairs and asphalt patching repairs will occur all week.
- NOTE: Wear Course Paving is expected to be completed the week of 8/25.We will notify you when a specific day is set. Paving notes to prepare for:
- No Street Parking allowed, please keep vehicles in driveways or parked on another street off-site. Everyone should have access in and out of driveways and throughout the site during paving, but delays should be expected if the operation is in front of your house and you need to enter or leave your driveway. You may need to wait until the paver and roller has passed through (15 to 30 minutes for cool down). Please be mindful that there will also be a tack coat placed prior to the paver making a pass. Be cautious of the tack coat as it is very sticky and shouldn't be driven on. The tack coat takes about 30 minutes to setup.
- No street Parking
- Residents can use parks or other streets outside of the project for parking if needing to leave during the day.
Questions? Please call Kale at 952-292-2221.
Thank you.
-
August 11, 2025
Share August 11, 2025 on Facebook Share August 11, 2025 on Twitter Share August 11, 2025 on Linkedin Email August 11, 2025 linkThis week, crews will be all about on-site restoration for disturbed areas due to construction activities.
- Restoration will be taking place behind the backs of curb, the sides of driveways, sidewalks and trails. Crews will be placing topsoil first and following through with placing rolls of sod.
- Irrigation systems: Crews will be repairing irrigation systems this week during restoration. If it was discussed to have your own irrigation contractors complete work, please coordinate with your contractor to fix these systems as soon as possible.
- If any of your landscaping was disturbed during construction, such as, mulch beds, rock, plants, etc., please let us know at this time so we can have them be replaced with match-like materials.
Questions: Contact Kale at 612-292-2221 with any questions or concerns about the project.
-
August 4, 2025
Share August 4, 2025 on Facebook Share August 4, 2025 on Twitter Share August 4, 2025 on Linkedin Email August 4, 2025 linkConstruction work will be minimal this week. Restoration work is anticipated to begin the week of August 11.
-
Another Update for 6/28
Share Another Update for 6/28 on Facebook Share Another Update for 6/28 on Twitter Share Another Update for 6/28 on Linkedin Email Another Update for 6/28 linkWe have just been notified that the Contractor may be doing driveways as early as tomorrow. If they are not able to do it Tuesday, it will be Thursday.
-
July 28
Share July 28 on Facebook Share July 28 on Twitter Share July 28 on Linkedin Email July 28 linkUnfortunately, there has been some delays due to the rain. Weather permitting, crews are planning to finish driveways on Thursday, July 31.
Questions: Contact Kale at 612-292-2221 with any questions or concerns about the project.
Thank you for your patience!
-
July 17 - 25
Share July 17 - 25 on Facebook Share July 17 - 25 on Twitter Share July 17 - 25 on Linkedin Email July 17 - 25 linkJuly 17 - 18
- Notices were sent out on Monday regarding reinstalling your mailboxes. Crews will be working on reinstalling all permanent mailboxes and removing the temporary mailboxes. Once all mailboxes are back up, mail will resume as normal. Our crews will notify you if they have any issues with your installation.
- Crews will be on-site though out the project to pave full length driveways.
July 21 - 25
- Crews will be removing marked driveway ends though out the project and will work on paving them until finished.
Access During Driveway Paving: If the paving equipment is working directly in front of your home, you may need to wait 15 - 30 minutes for the asphalt to cool down before driving over it.
If you have any questions, contact Kale at 952-252-2221.
-
Construction Update July 10.
Share Construction Update July 10. on Facebook Share Construction Update July 10. on Twitter Share Construction Update July 10. on Linkedin Email Construction Update July 10. linkUnfortunately, paving had to be postponed today due to the rain. Paving should resume on Friday and will include Alabama Avenue, Xenwood Avenue, 137th Street E, Yosemite Avenue and 147th Street. We anticipate paving to be completed by the end of the day on Friday.
Access During Paving: You'll still be able to get in and out of your driveway throughout the paving process. However, if the paving equipment is working directly in front of your home, you may need to wait 15 - 30 minutes for the asphalt to cool down before driving over it. Our crew will help coordinate your access and get you in and out as quickly as possible.
Safety Reminders: Please drive carefully through the construction area. You may need to navigate around equipment, and conditions can change throughout the day.
Questions: Contact Kale at 612-292-2221 with any questions or concerns about the project.
-
July 8, 2025
Share July 8, 2025 on Facebook Share July 8, 2025 on Twitter Share July 8, 2025 on Linkedin Email July 8, 2025 linkXcel Energy / Michels Pipeline is currently working within the project area replacing faulty underground power lines. This work is outside of the road construction project work scope. If you have any questions, regarding this particular work, please contact Bridget with Xcel Energy at 651-229-5555. Thank you.
-
July 7 - 10, 2025
Share July 7 - 10, 2025 on Facebook Share July 7 - 10, 2025 on Twitter Share July 7 - 10, 2025 on Linkedin Email July 7 - 10, 2025 link- Monday, July 7: Finish grading and compaction and crews continuing to raise utility castings within the street section throughout the site.
- Tuesday, July 8: Finish raising utility castings within the street section throughout the site.
- Wednesday & Thursday, July 9 & 10: Paving will begin on Alabama, 136th St, Zarthan, 136th Ln, Brunswick, 139th (west), Colorado, 137th (west). No street parking during paving.
Things to know for Paving: No Street Parking allowed, please keep vehicles in driveways or parked on another street off-site. Everyone should have access in and out of driveways and throughout the site during paving. If the operation is in front of your house and you need to enter or leave your driveway, you may need to wait until the paver and roller has passed through (15 to 30 minutes for cool down). This will be situational, and we will get you in and out as promptly as possible. Please be cautious while driving around the site as you may need to drive around equipment.
Please call Kale at 612-292-2221 with any questions.
-
June 30, 2025
Share June 30, 2025 on Facebook Share June 30, 2025 on Twitter Share June 30, 2025 on Linkedin Email June 30, 2025 linkDue to weather, there will be no paving on Wednesday, July 2. More updates will be coming as we learn more.
Thank you.
Follow Project
Who's Listening
-
Engineer Technician I
Phone 952-882-2672 Email kmilek@savagemn.gov -
Phone 9528822671 Email smeyer@savagemn.gov
